Close-Out Task Order - NPS
Process map & training guides on how to close out task orders on non project specific (NPS) Professional Services contracts.
Close-Out Task Order on Professional Services NPS Contracts
Training Guides
Training materials are in development and will be uploaded upon completion. Training guides correspond to step numbers in the process map.

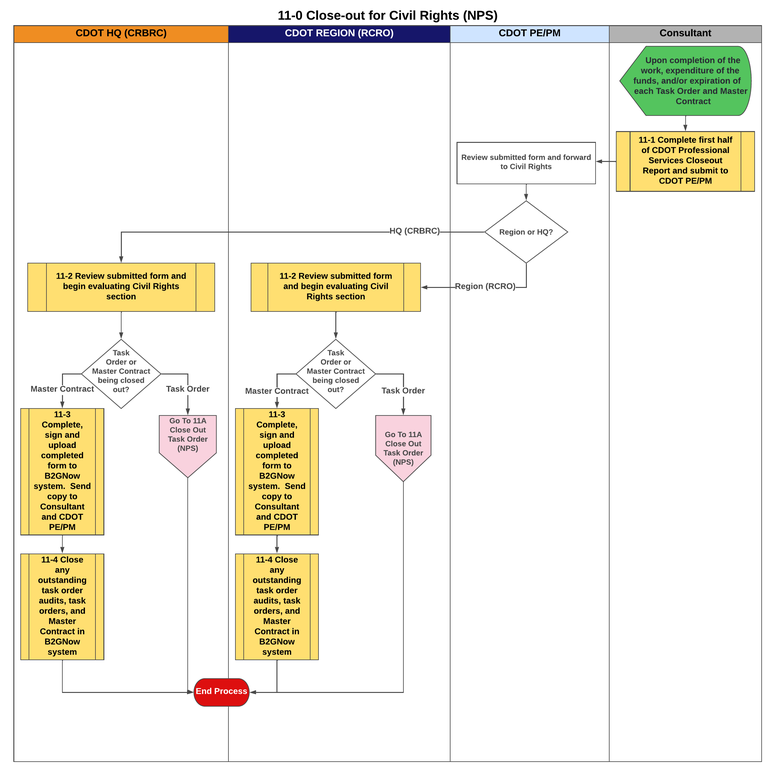

11-0 Close-Out for Civil Rights
11A-0 Close-Out for Civil Rights
- No training guides. Review process map for details.
11-0 Close-Out for Civil Rights
- No training guides. Review process map for details.

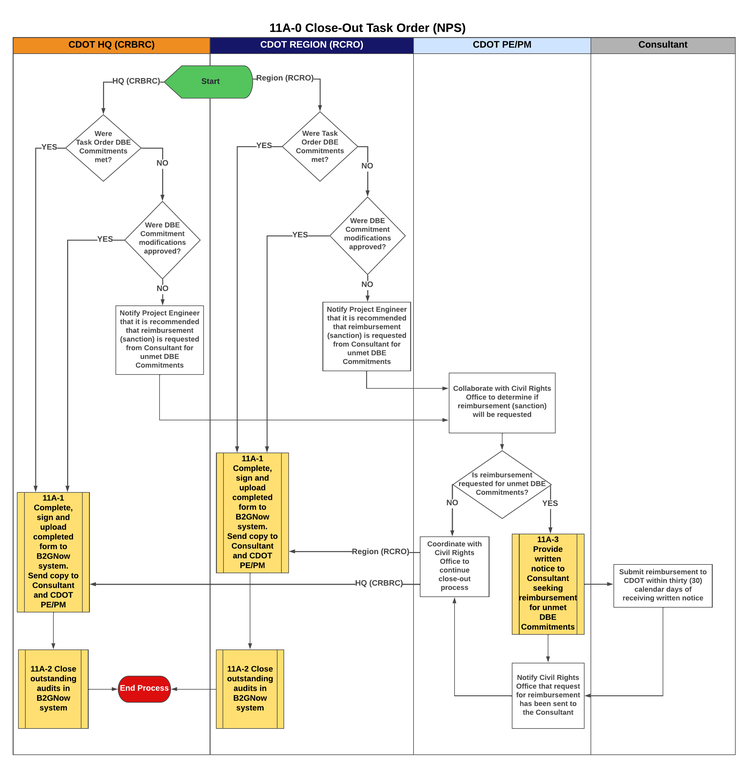

11A-0 Close-Out for Civil Rights
- 11A-3 Provide Written Notice to Consultant
11-0 Close-Out for Civil Rights
- 11-2 Review Submitted Form and Begin Evaluating Civil Rights Section
- 11-3 Complete Form
- 11-4 Close Outstanding Task Order Audits, Task Orders, and Master Contract
11A-0 Close-Out for Civil Rights
- 11A-1 Complete Form
- 11A-2 Close Outstanding Audits
State email address required to access Civil Rights documents
Process Maps
Download PDF of Close-Out for Civil Rights process map (print-friendly)
Download PDF of Close-Out Task Order process map (print-friendly)
